Hiring a Flooring Specialist NZ Guide

Flooring is the trade where a homeowner can ask for one number and instantly tell a professional from a guesser. That number is the moisture reading. Most flooring failures we hear about — the bubbling vinyl, the cupped timber, the adhesive that let go eight months after the job — trace back to a subfloor that was never properly tested before anything was laid on top of it.

What makes this frustrating is that the standards are not secret. There are clear thresholds for concrete and timber, published installation standards, and a set of best practice guidelines the industry works to. The problem is that nobody asks for the readings in writing before the floor goes down, so when it fails, the installer blames the slab, the supplier blames the installer, and the homeowner is left holding a receipt and a wavy floor.

This guide covers what a flooring specialist actually does, what credentials exist (and which ones do not), the moisture numbers that matter, and the specific questions that separate a careful installer from a cheap one.

How We Researched This Guide

We worked from the FloorNZ Best Practice Guidelines for resilient and carpet floor coverings, the BRANZ bulletins on measuring moisture in timber and concrete, and the installation standards themselves — NZS/AS 1884:2013 for resilient sheet and tiles, AS/NZS 2455.1:2007 for carpet, and NZS 3602:2003 for timber. The moisture thresholds in this article are the ones those documents specify, not our own rules of thumb.

One thing that surprised us: the concrete threshold is 75% relative humidity or less, measured with a hygrometer, and the Building Code's Acceptable Solution E2/AS1, set out on legislation.govt.nz, recognises the same method. In-slab humidity probes are permitted as an alternative and give a truer picture of conditions inside the concrete rather than what is transferring from the surface. The consumer rights position is in the Consumer Guarantees Act 1993.

ValueHub's Trusted Providers

We've researched the providers below — here are our picks for this category.

The Quick Summary (60-Second Version)

If you read nothing else, read this.

  • Flooring installers are not licensed in New Zealand, so there is no register to check — the substitute is references, insurance, and a written scope.
  • Ask for subfloor moisture readings in writing before installation. Concrete should read 75% relative humidity or less; timber should read under 16% moisture content.
  • A written quote should separate labour, materials, subfloor preparation, old flooring removal and disposal, and state whether GST is included.
  • Get at least three quotes and compare the scope, not just the price — the cheapest quote is usually the one with the narrowest scope.
  • Photograph the room before work starts, and photograph the subfloor once it is exposed.
  • If something goes wrong, give the installer a chance to fix it first, in writing — that step protects your rights.

What a Flooring Specialist Actually Does

The visible part of the job is laying material. The part that determines whether the floor lasts is everything underneath it. A competent installer assesses the subfloor, measures its moisture content, checks whether it is level and structurally sound, and works out what preparation is needed before a single board or tile goes down.

The FloorNZ guidelines are explicit that information gathered from the customer and about the site during planning should be used to match both an appropriate floor covering and appropriate installation materials to the environment it is going into. In areas where heat, ultra-violet light, water or moisture will affect performance, the appropriate adhesive, moisture treatment type and surface preparation system should be used according to the manufacturer's specifications.

Where the failures come from

High subfloor moisture causes floor coverings to swell or bubble, underlayment and patching compounds to lift, and carpet gripper pins to rust — which stains the carpet and grows mould in the backing. New concrete that has not dried sufficiently can have high pH levels that break down the adhesive bond, and those problems may not show up for several months.

This is why the guidelines insist that if there are concerns about a damp timber subfloor, the client must be told so the problem can be looked at by the appropriate trade. No work should start until moisture tests confirm the timber is dry. Timber takes a considerable amount of time to dry once it has been wet.

The Moisture Numbers That Decide the Job

These are the thresholds an installer should be working to, and the ones you should ask to see recorded.

Subfloor or materialAcceptable readingHow it is measured
Concrete slab75% relative humidity or lessHygrometer, drill-and-plug or surface-mount; in-slab humidity probe also permitted
Timber subfloor (plywood, particleboard, fibre-cement)Under 16% moisture contentPin (resistance) test
Timber flooring, air-conditioned or centrally heated8–12% moisture contentPer NZS 3602:2003
Timber flooring, unheated building12–16% moisture contentPer NZS 3602:2003
Post-flood subfloorBelow 16%, and within 2% of dry areas nearbyPin test, compared against unaffected areas

If a reading comes back above the threshold, the conversation should change. Either the moisture treatment system goes in, or the job waits. What should not happen is the flooring going down anyway with a shrug.

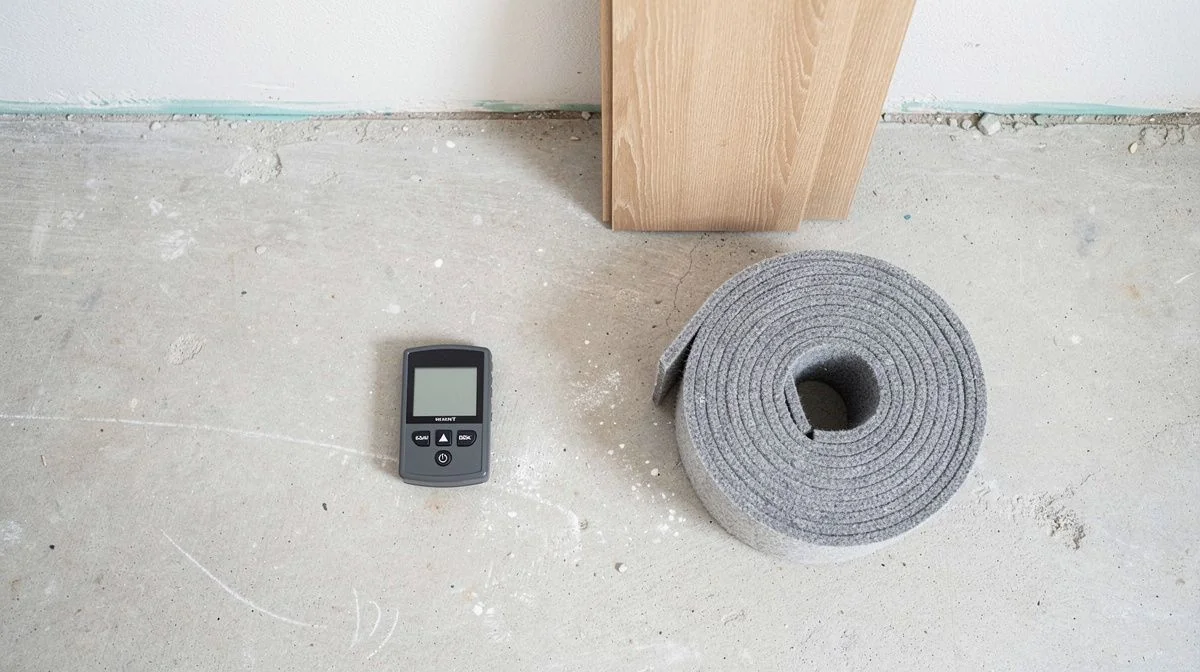

Empty room with concrete slab, moisture meter, underlay coil and timber planks

What a competent installer's work looks like

Beyond moisture, there are details that signal someone knows the trade. Solid timber strip flooring over a concrete slab should be laid with an 8–10 mm gap around the perimeter to allow for movement, covered by the skirting. Boards should be laid with randomly staggered end joints. Where flooring goes over timber battens, the battens should be at a similar moisture content to the floorboards.

The standards a professional works to include NZS/AS 1884:2013 for resilient sheet and tiles, AS/NZS 2455.1:2007 for carpet, ISO 10874:2009 for classification, and AS/NZS 1080.1:2012 for timber moisture testing. The manufacturer's own installation specification governs the product warranty, and it usually assumes all of the above has been done.

Quotes, Credentials and Consumer Rights

There is no licensing regime for floor laying in New Zealand, so the checks are the same as for any unlicensed trade: references from recent local jobs, evidence of public liability insurance, a company registration, and a written contract. The absence of a licence does not mean there is no way to check anyone.

A quote is a fixed price for defined work. An estimate is an approximation and can legitimately be exceeded. Ask for a quote. Confirm whether GST is included, because a 15% difference between two quotes can be entirely an accounting difference rather than a price difference. Extra work found after starting — rot, an uneven slab, an unseen leak — should go through a written variation process agreed in advance.

Your rights if the floor fails

Floor coverings must be of acceptable quality and the installation must be carried out with reasonable care and skill under the Consumer Guarantees Act 1993. That applies regardless of what the contract says. If the work is faulty, you must give the installer the chance to put it right within a reasonable time first. Skip that step and you can lose your right to a remedy.

If they refuse, or try and fail, you can have it fixed elsewhere and recover reasonable costs, or cancel the contract. You can also claim for damage the work caused to other property. The Disputes Tribunal handles claims up to $60,000, with fees starting at $62 for claims under $2,000.

Questions You Might Have

Do I need a Licensed Building Practitioner for flooring?

Usually not. Floor laying is not restricted building work. But if the project involves structural subfloor repairs, new floor joists, or anything that contributes to the home's primary structure, that work is restricted building work and needs an LBP in the correct class — generally Carpentry or Foundations. Ask before assuming.

How much does flooring cost per square metre?

We are not going to invent a price range, because there is no authoritative NZ data behind the numbers that get quoted online. What drives the cost is the material you choose, the condition of the subfloor, the complexity of the room, access, and whether old flooring needs removing and disposing of. Ask each installer to itemise those separately so you can compare scopes properly.

How long should the flooring sit in the house before installation?

Most materials need to acclimatise to the room's temperature and humidity before being laid. The exact period depends on the product and the manufacturer's instructions, so ask your installer what they require and confirm it against the product documentation. The moisture content of timber flooring should be close to the expected average in-service moisture content for your home.

What if the floor bubbles or lifts months later?

That is usually a moisture problem, and the first question is whether readings were taken and recorded before installation. Put your complaint in writing to the installer and give them a reasonable chance to inspect and fix it. Keep photographs, the quote, and any moisture records. If they will not engage, the Disputes Tribunal is the next step.

Is a workmanship warranty separate from my Consumer Guarantees Act rights?

Yes, and it sits on top of them rather than replacing them. A trader cannot contract out of the Act's guarantees for consumer work, so a one-year warranty promise does not limit your statutory rights where a failure is substantial. Ask what the warranty covers, who honours it if the installer stops trading, and get it in writing.

What Matters Most

The single highest-value thing you can do on a flooring job costs nothing and takes one sentence: ask for the subfloor moisture readings in writing before installation starts. It changes the conversation from opinion to measurement, and it gives you evidence if the floor fails later.

Everything else follows from that. Get a written quote with the scope itemised, confirm GST, agree a variation process, and photograph the room before work begins. Give the installer a proper chance to fix any problem before you consider anyone else — that step is what keeps your rights intact.

A floor is one of the few things in a house you will live with every day, and one of the hardest to argue about after the fact. Set the standard before the first board goes down.
